Mascot Project List

--:--:-- WIB -- --- ----
Login
Kleig
Compressed Foam In Progress Priority: Normal
Deadline: 27 Jun 2025
Quantity: 1

No Submission Notes yet

waiting silicon and find the right color, when can take photo after adjust?

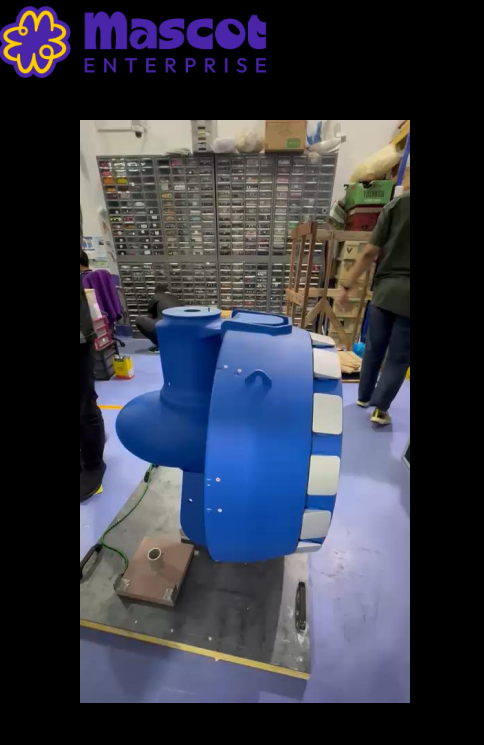

3D Fan Repair 3D printing
Props In Progress Priority: Normal
Deadline: 26 Aug 2025
Quantity: 1

No Submission Notes yet

waiting client confirmation to continue the adjustment or not

Loti Bread inflatable
Inflatable In Progress Priority: Normal
Deadline: 15 Oct 2025
Quantity: 1

process making structure
06/10/2025
* adjust the viewing

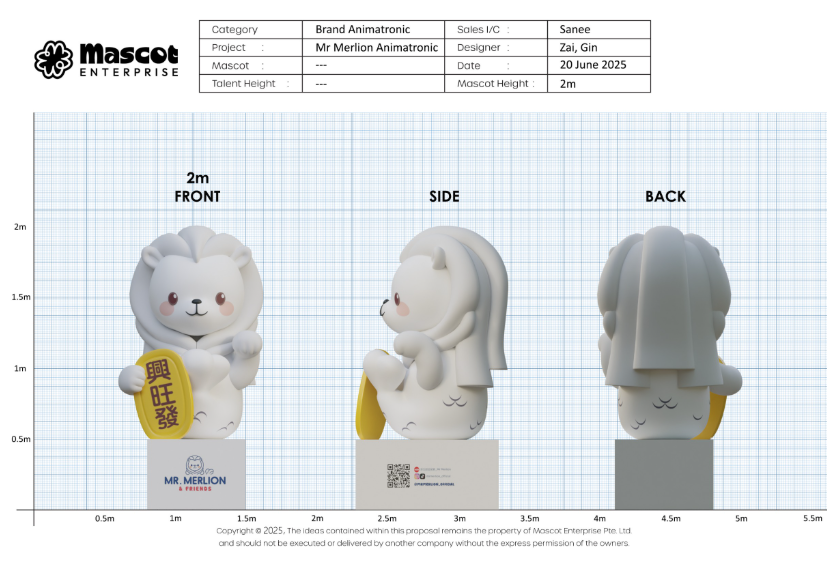

Mr Merlion Animatronic
Statue In Progress Priority: Urgent
Deadline: 16 Oct 2025
Quantity: 1

waiting client confirmation before wrap
18/08/2025
* need to adjust the eyes make it looks bigger - shave the eyes
25/08/2025
* proceed airbrush the blush and take photo today
13/10/2025
* adjust the eyes make it bigger

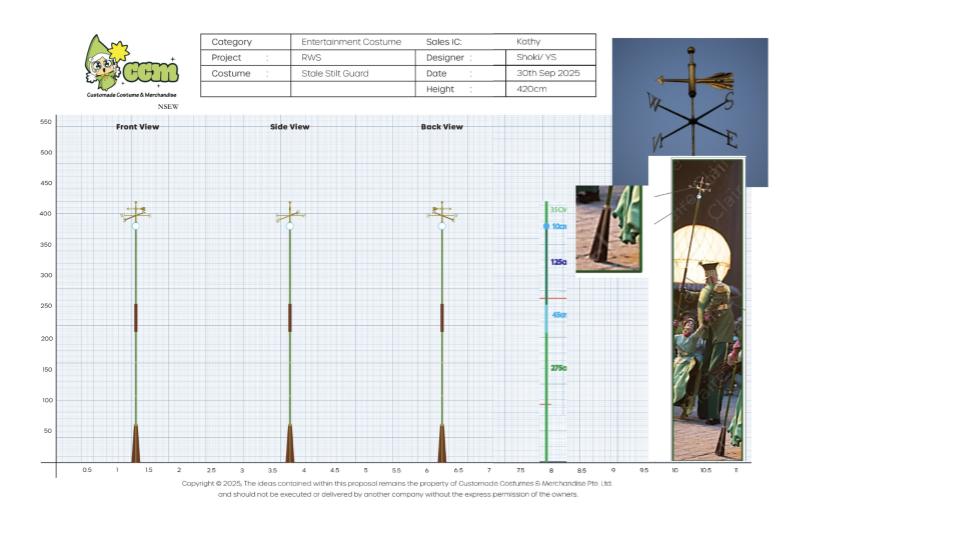

RWS STILT GALE FORCE GUARDS
Props In Progress Priority: Urgent
Deadline: 19 Oct 2025
Quantity: 1

No Submission Notes yet

13/10/2025
* process adjusting

big and lil brother repair
Compressed Foam In Progress Priority: Urgent
Deadline: 21 Oct 2025
Quantity: 2

No Submission Notes yet

process wrapping

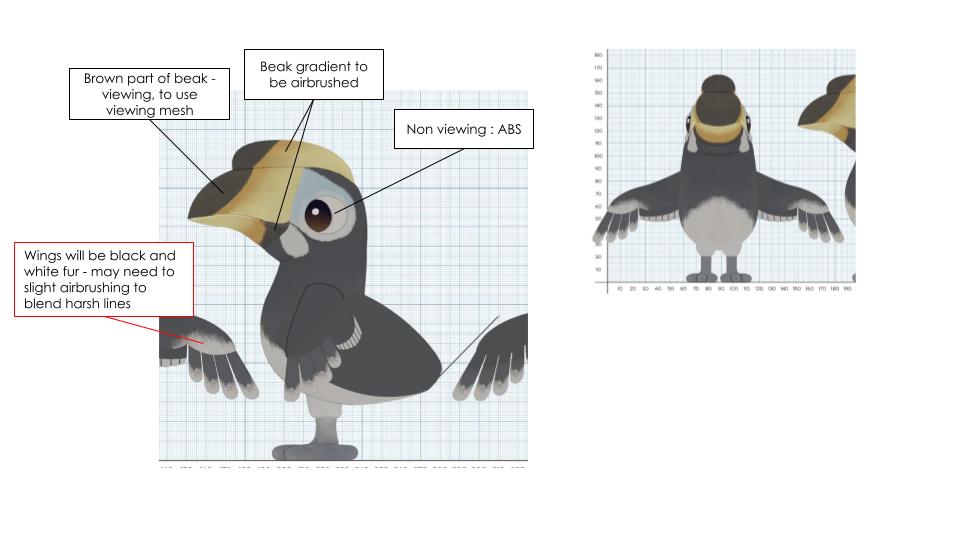

Mandai Inflatable - Coco & Sally
Inflatable In Progress Priority: Urgent
Deadline: 22 Oct 2025
Quantity: 2

26/09/2025
* process make draft
13/10/2025
* process making structure
18/10/2025
* sally process wrapping

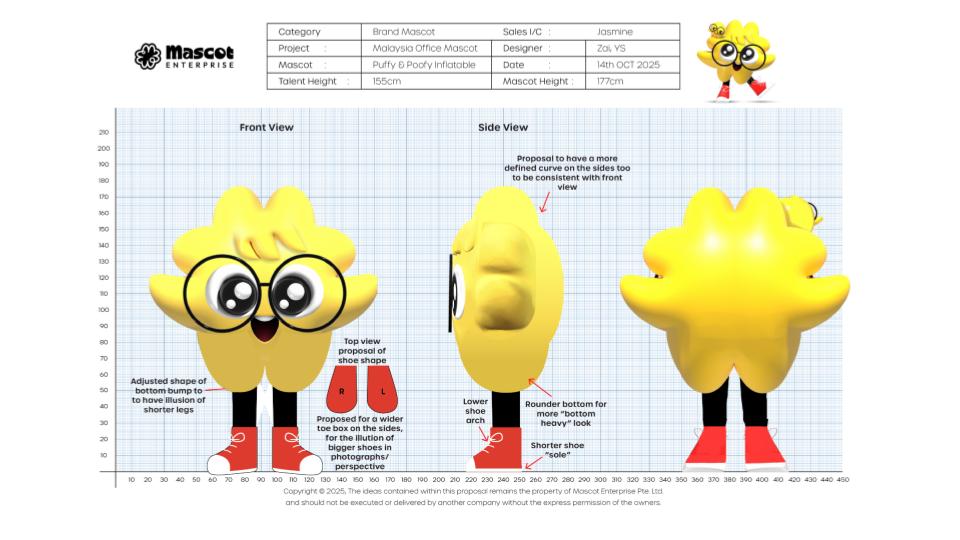

Poofy Inflatable + Magnet stick on Puffy - Magnet expression (eye or mouth?) - Overlay - xmas/ cny/ raya/ deepavali
Inflatable In Progress Priority: Normal
Deadline: 22 Oct 2025
Quantity: 1

Waiting design stage and submission form

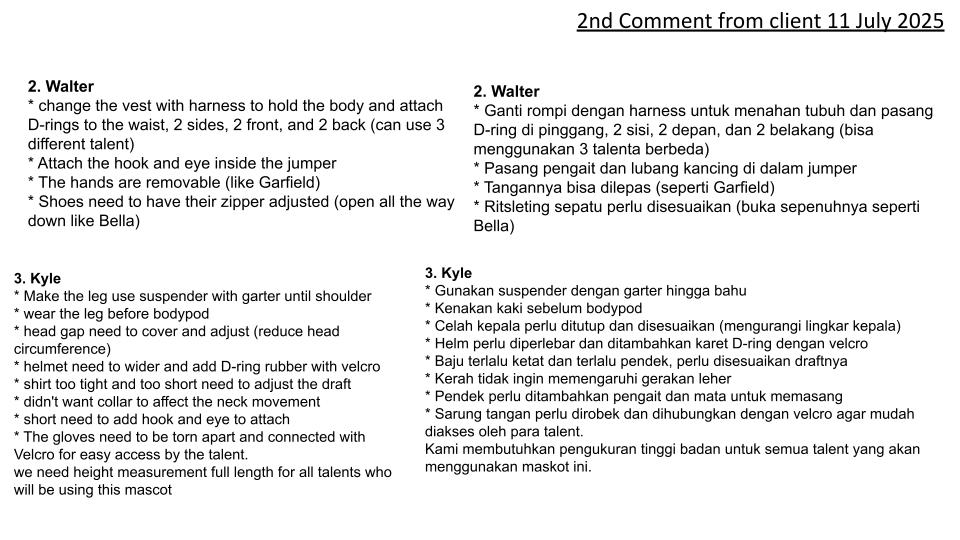

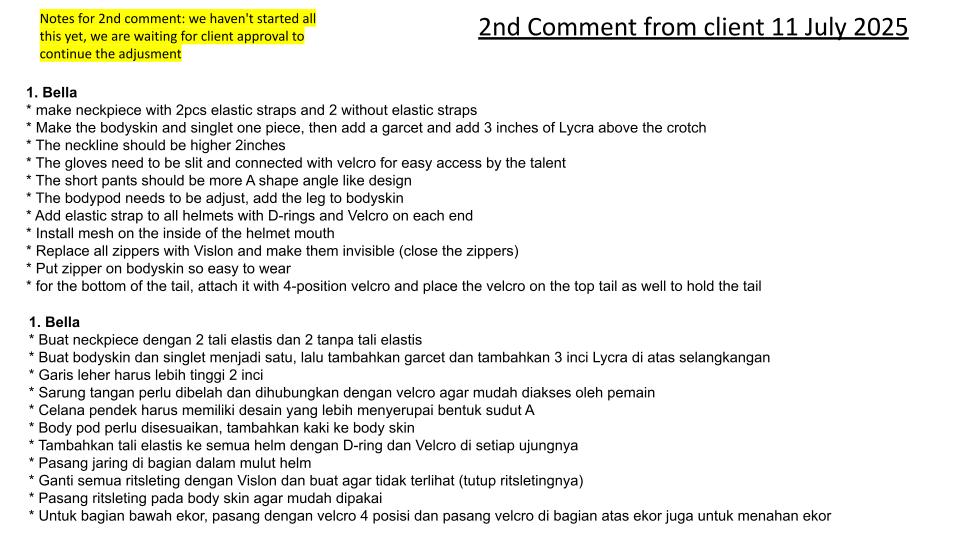

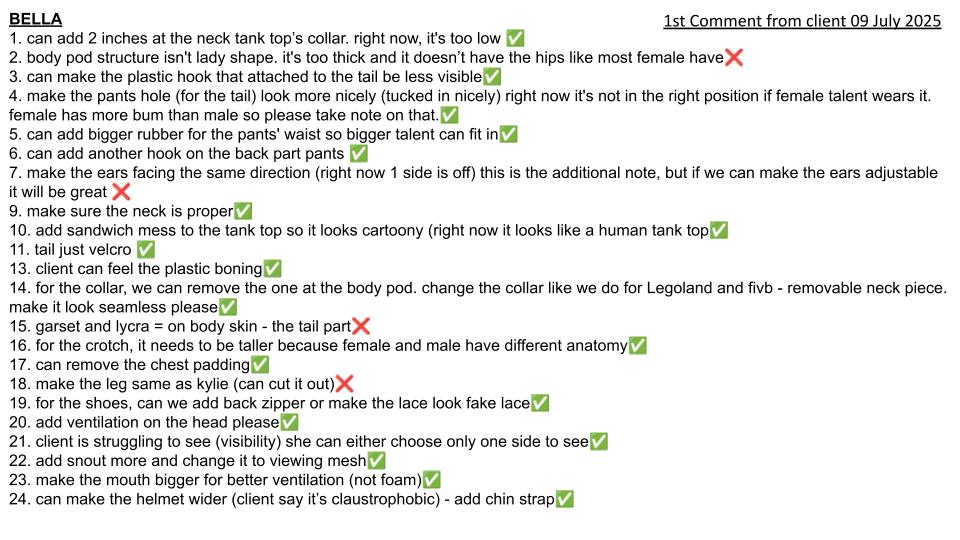

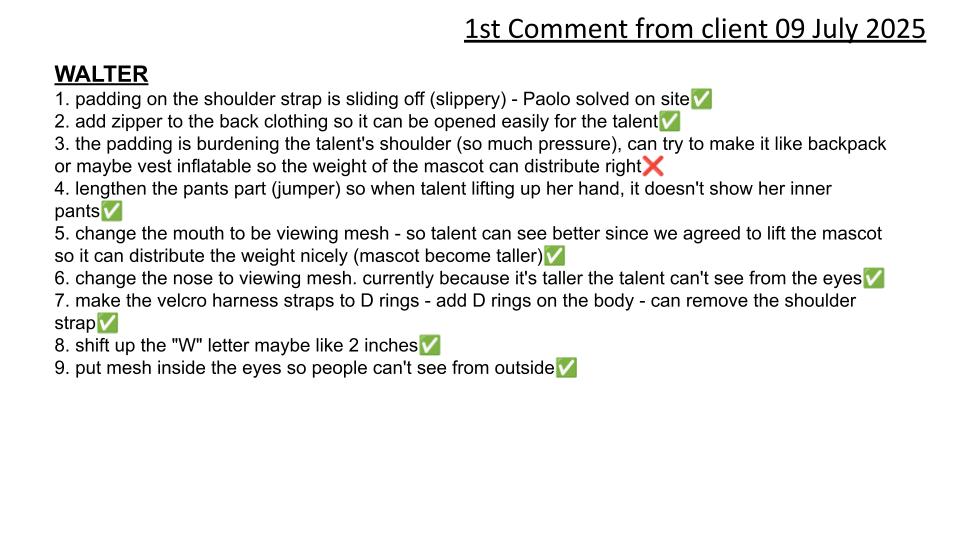

Australia dreamworld-Kyle
Compressed Foam In Progress Priority: Urgent
Deadline: 22 Oct 2025
Quantity: 1

25/08/2025
* Process adjust based on client comment and take photo monday and line up
16/09/2025
* waiting client confirmation after adjust
13/10/2025
* process adjusting

Shangri La Rasa Ria - Tawan Inflatable
Inflatable In Progress Priority: Normal
Deadline: 23 Oct 2025
Quantity: 1

No Submission Notes yet

22/10/2025
* process making structure

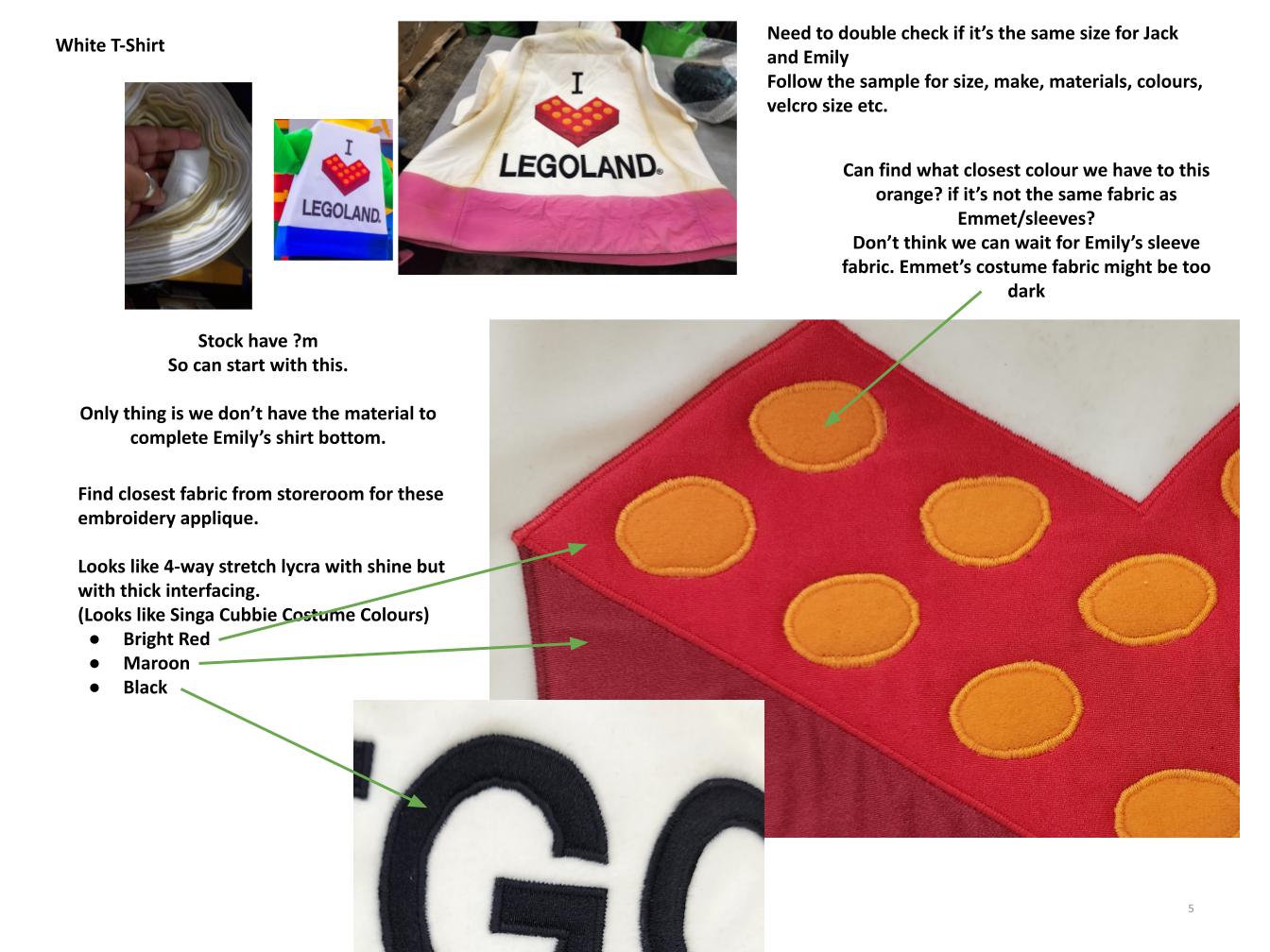

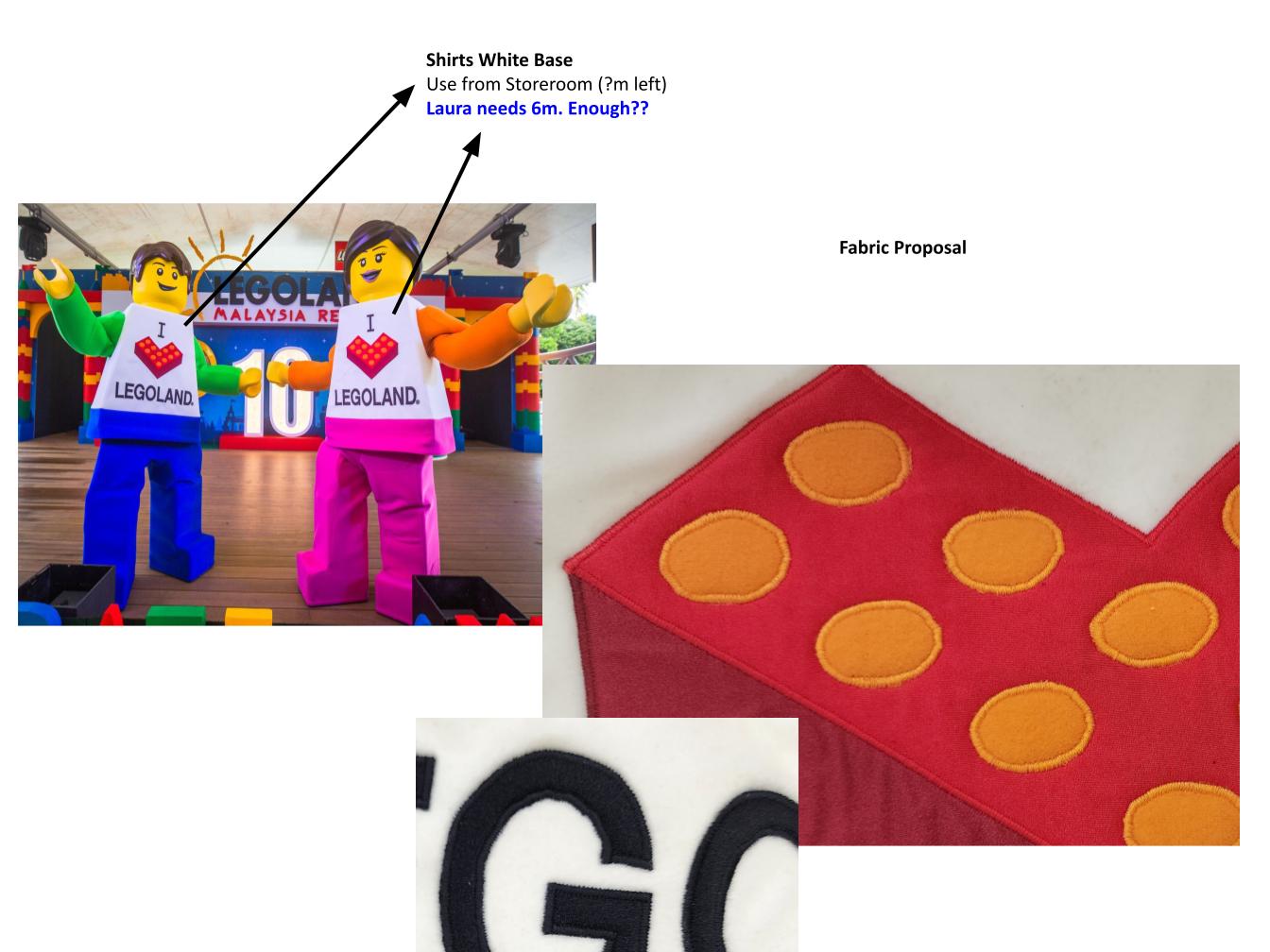

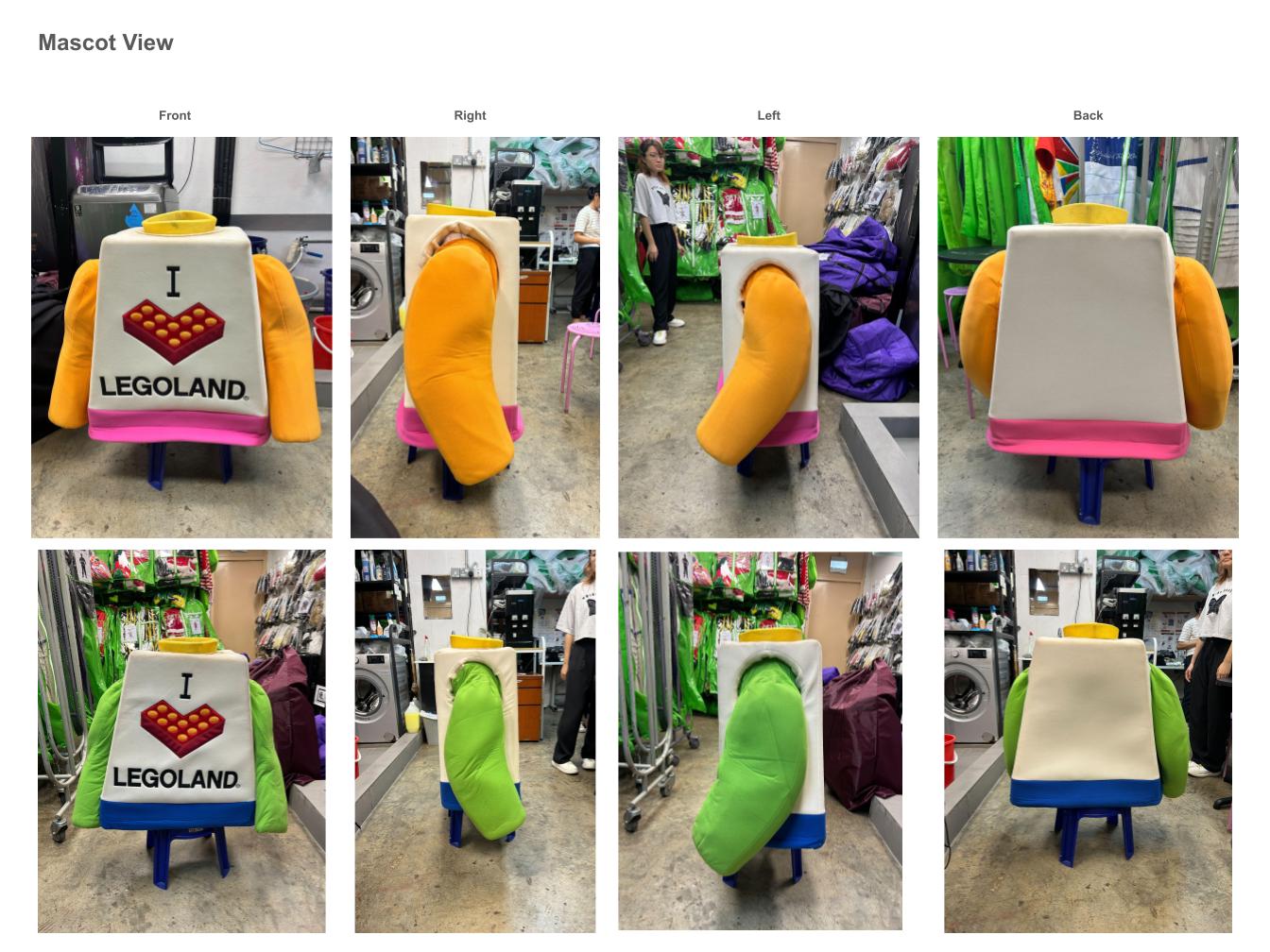

Legoland Reskin - Jack and Emily
Compressed Foam In Progress Priority: Urgent
Deadline: 24 Oct 2025
Quantity: 2

13/10/2025
* can start embroidery and reskin

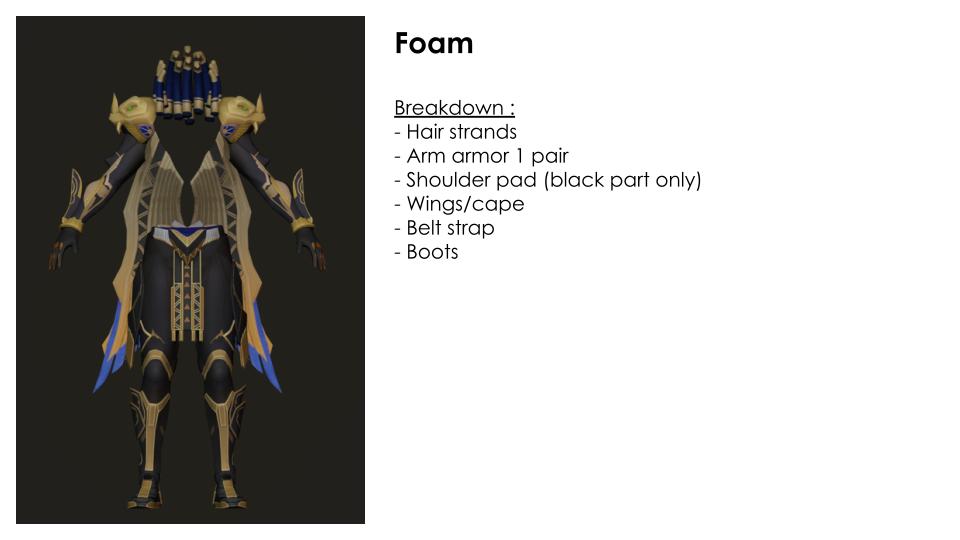

PubG Pharoh Character
Compressed Foam In Progress Priority: Urgent
Deadline: 24 Oct 2025
Quantity: 2

06/10/2025
* process making draft
13/10/2025
* waiting impose
18/10/2025
* process wrapping and airbrush

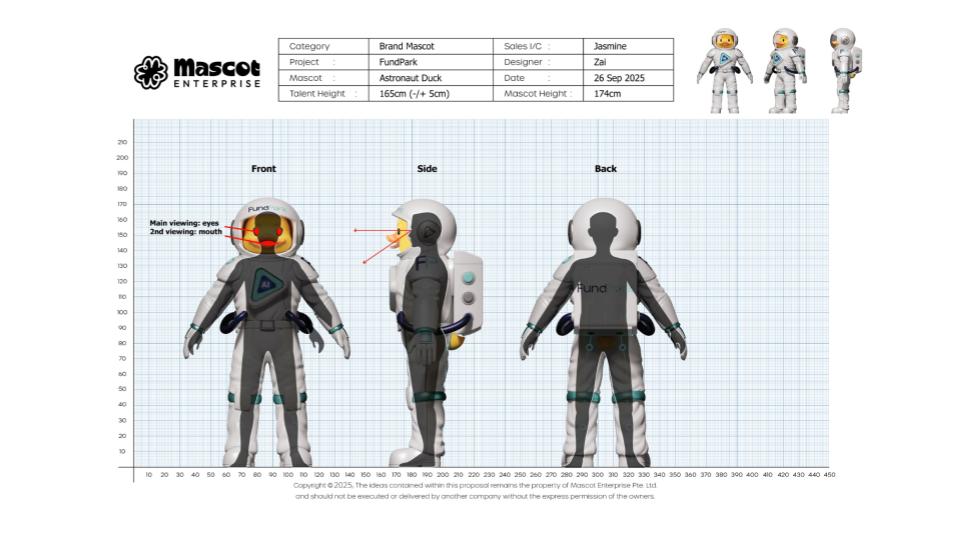

Mascottist Duck Astronaut
ABS In Progress Priority: Urgent
Deadline: 24 Oct 2025
Quantity: 1

26/09/2025
* waiting draft can proceed wrap

Disney Indonesia : Predator Badlands Mask
Props In Progress Priority: Urgent
Deadline: 24 Oct 2025
Quantity: 100

No Submission Notes yet

18/08/2025
* need to do sample, waiting 3d mold
25/08/2025
* waiting design confirm to print mask to make sample
03/09/2025
* adjust the sample again
09/09/2025
* adjust the color for approval
15/09/2025
* process molding new mask
26/09/2025
* need to adjust the color for the sample
06/10/2025
* waiting the mold, and moldin the mask
13/10/2025
* process molding and airbrushing

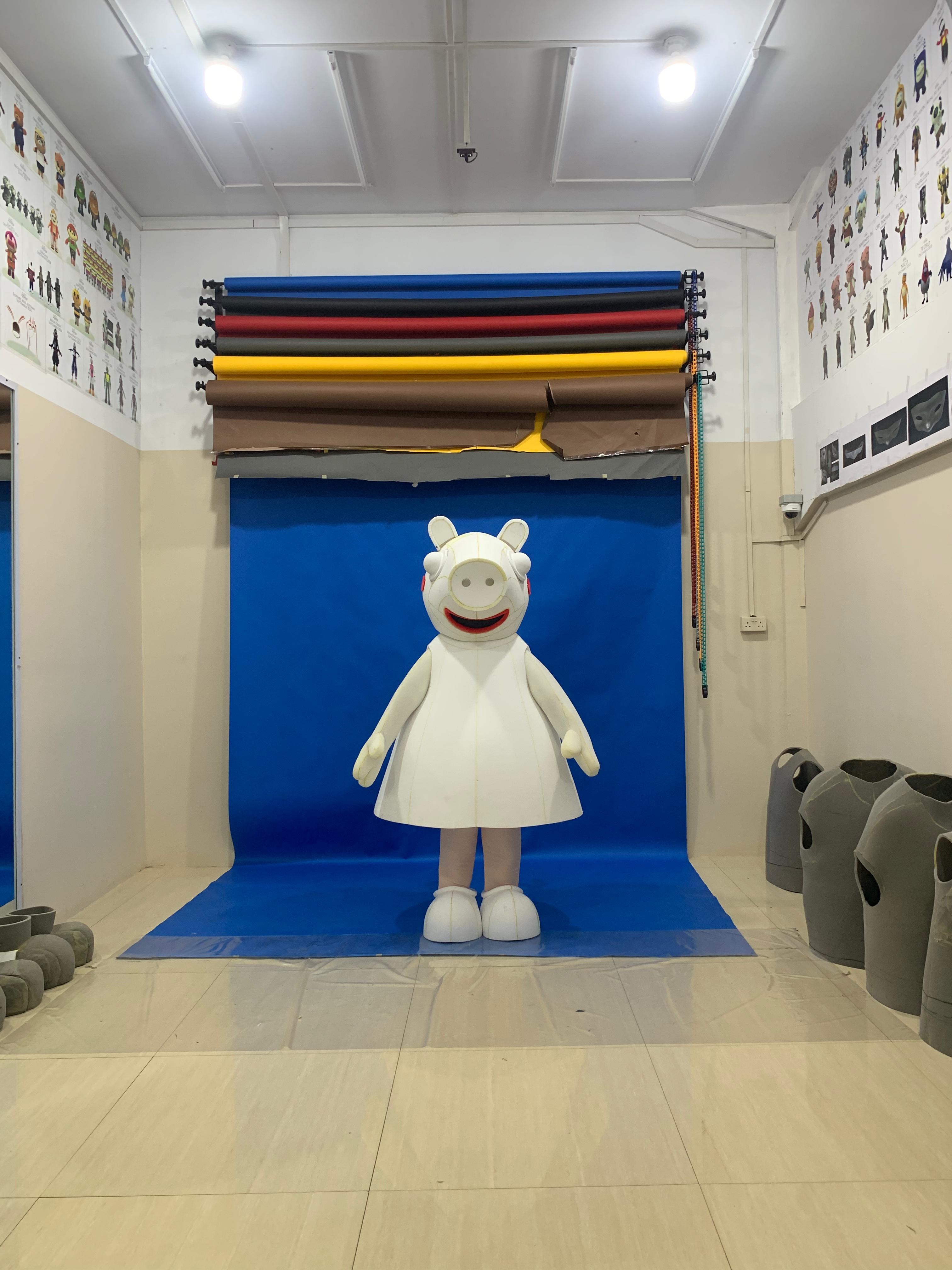

Peppa Pig
Compressed Foam In Progress Priority: Normal
Deadline: 24 Oct 2025
Quantity: 1

11/08/2025
*proces making strutcure and today must take photo
18/08/2025
* waiting impose after adjust the 1st structure
03/09/2025
* Waiting client
15/09/2025
waiting client confirmation

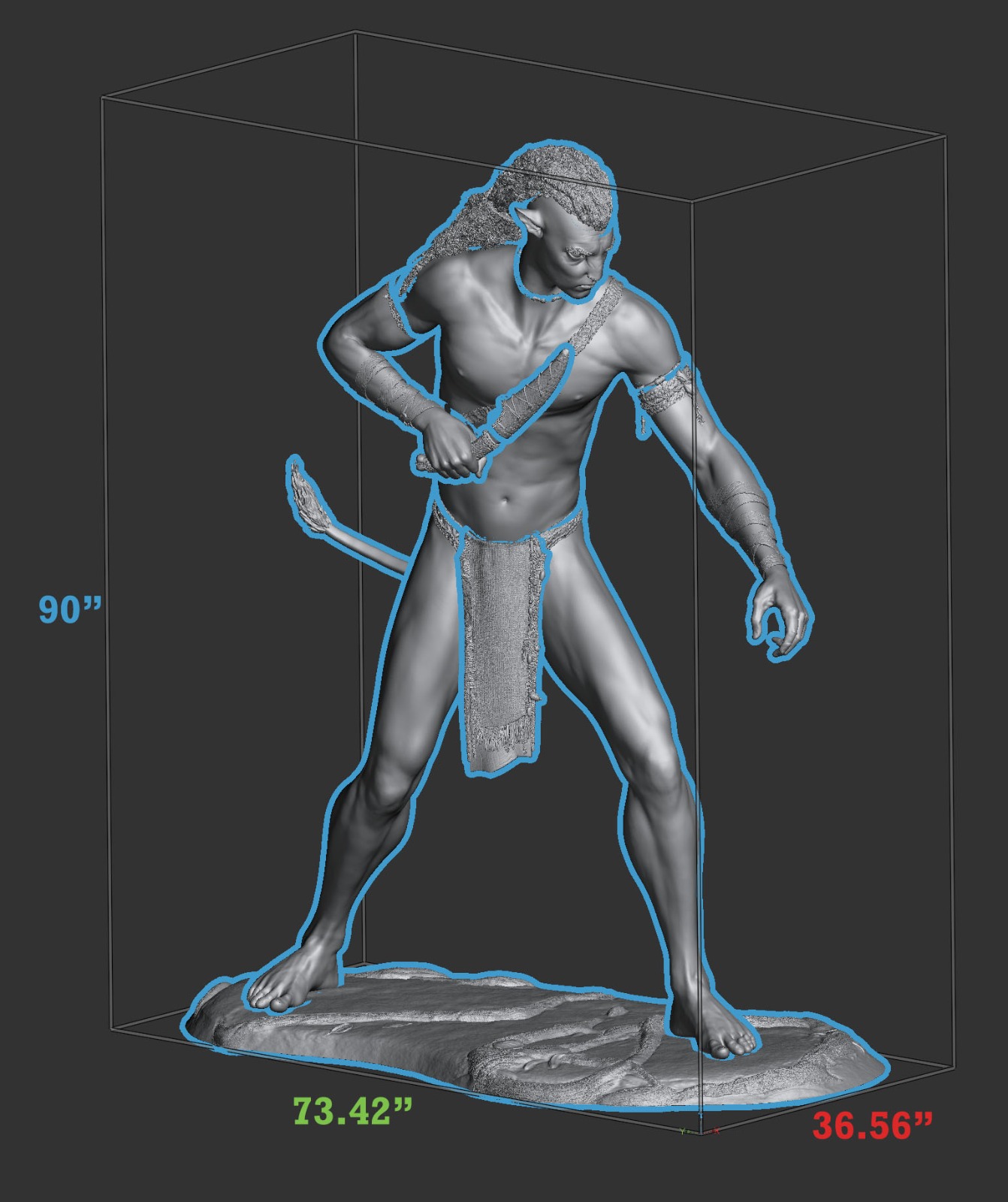

Disney Indoensia Avatar : JAKE & NEYTIRI
Statue In Progress Priority: Urgent
Deadline: 25 Oct 2025
Quantity: 2

No Submission Notes yet

13/10/2025
* Jake process sanding
* Neytiri process printing

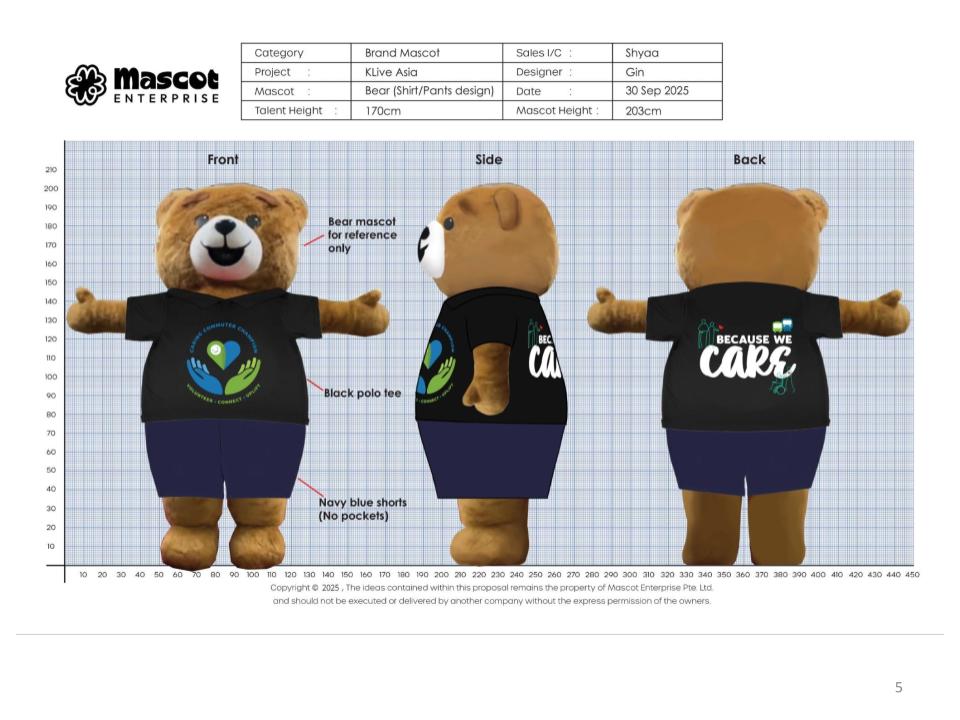

Bear Mascot Costume
Compressed Foam In Progress Priority: Normal
Deadline: 27 Oct 2025
Quantity: 1

No Submission Notes yet

13/10/2025
* process making costume overlay

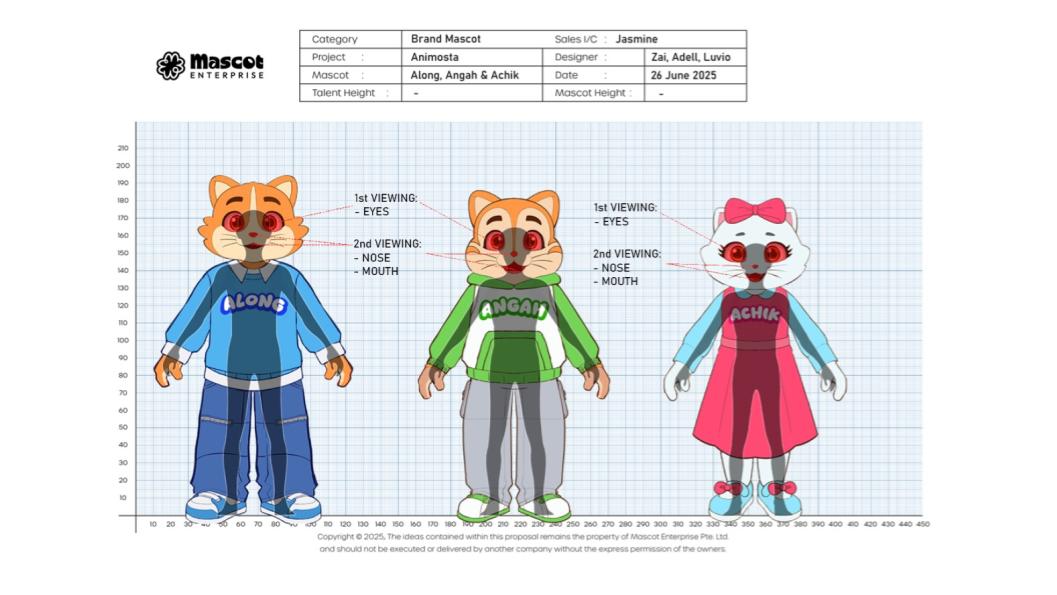

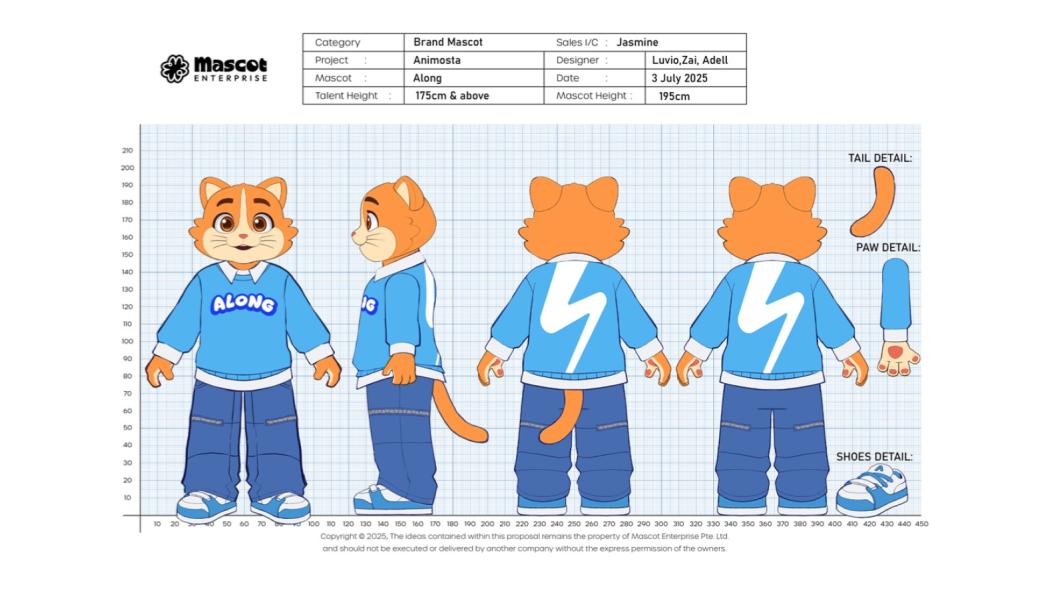

Along, Angah, Achik
ABS In Progress Priority: Urgent
Deadline: 27 Oct 2025
Quantity: 3

all the tail must same size and can bendable and detachable
* Along need to adjust based on impose
* Angah and Achik still making structure
all must take photo line up by tuesday
18/08/2025
* Process adjust the structure and take photo after
* Process print 3d face for the head
25/08/2025
* Waiting structure after adjust
* waiting material confirmation
04/08/2025
* process adjust based on impose
15/09/2025
* Along can start wrap
* Angah back head and pants need to adjust
* Achik take photo and start wrap
06/10/2025
* Process wrapping and take photo after
20/10/2025
* process adjusting

Celebration
